Process Knowledge

What affects CNC machining lead time?

What affects CNC lead time: shop queue, material stock, setups, secondary ops, inspection, revisions and incomplete RFQs — plus how buyers can shorten it.

By 3DWK Engineering Team · · 8 min read

Six CNC order stages from RFQ review to inspect and ship, each paired with a buyer lever that usually shortens that stage
Illustration: 3DWK original diagram (typical values, not to scale).

The short answer

CNC machining lead time is the calendar time from a complete RFQ to parts leaving the shop. On a typical job it is driven less by pure cutting time and more by what sits around the spindle: machine queue, material stock, setups, secondary ops such as heat treat or coating outside the shop, inspection depth, and open questions in the drawing package. Many shops quote standard jobs in about 5–15 business days once the order is released; complex multi-setup parts, exotic stock or outside finishing often take longer, and a thin RFQ can add clarification days before the clock starts.

This guide is for buyers and engineers who need a realistic date. It covers the drivers you can see from the outside, what a “standard” range usually means, and practical moves that shorten the path—without inventing shop-specific stats or prices. When you are ready, upload a STEP file and drawing on the 3DWK quote page (quote-new.php) so an engineer can review manufacturability and schedule assumptions together.

What “lead time” usually includes

Lead time is not the same as spindle hours. A part that cuts in two hours can still sit for a week if the machine is booked, bar stock has not arrived, or anodizing is waiting at an outside finisher. Most quotes bundle several stages into one ship date:

  • RFQ review and clarifying questions
  • Material purchase or pull from stock
  • CAM programming and fixture planning
  • Machine queue and actual cutting
  • Deburr, secondary ops and outside processes
  • Inspection, packing and ship

When a shop says “about 10 business days,” they mean the whole chain for a complete package, not cut time alone. Incomplete models, missing tolerances or “TBD” coatings push work back into the first stage and stretch everything after it.

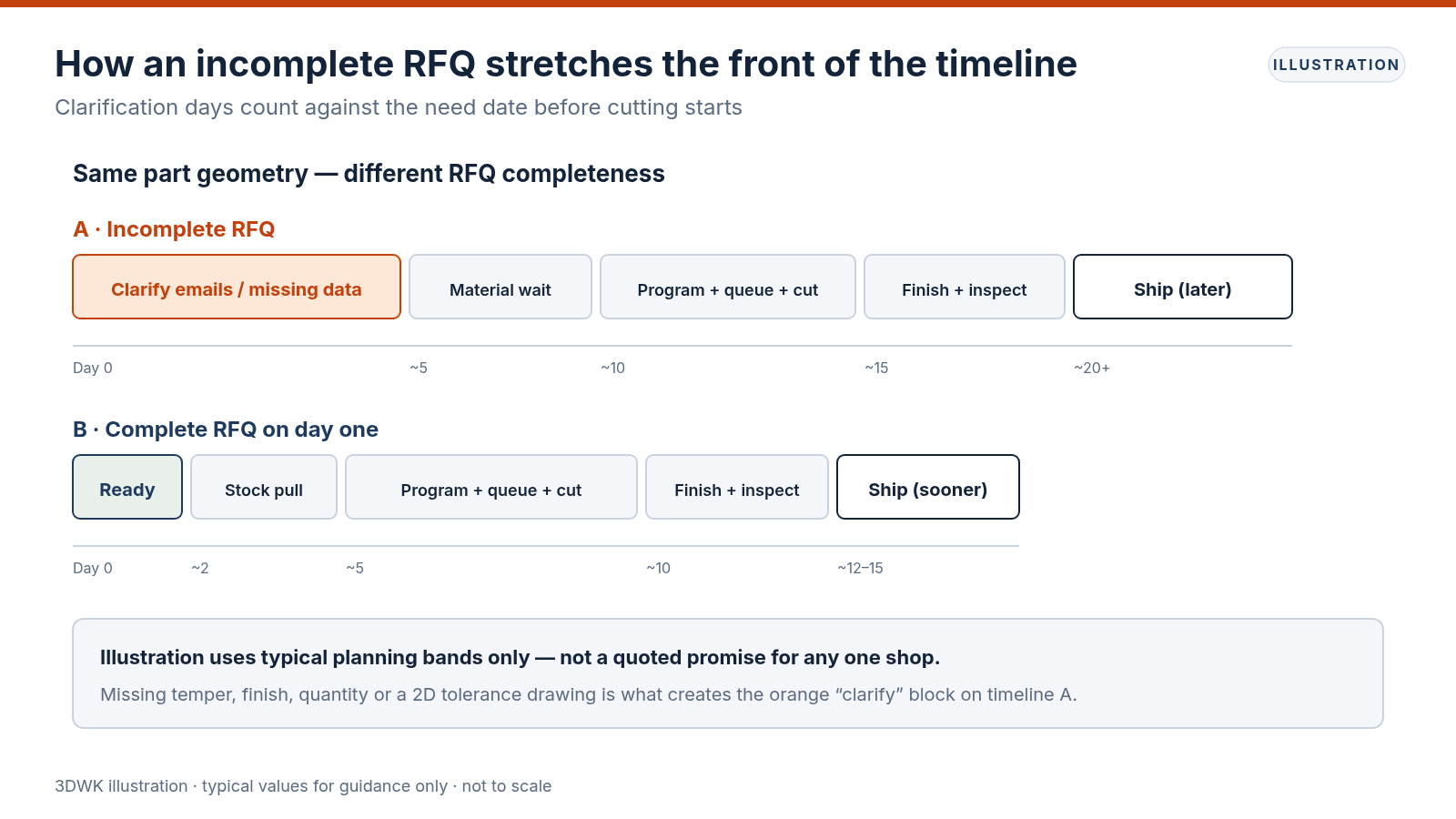

Two timelines comparing an incomplete RFQ that burns days on clarification against a complete RFQ that reaches ship sooner
Illustration: 3DWK original diagram (typical values, not to scale).

The main drivers, ranked by how often they move the date

DriverWhy it adds daysWhat a buyer can do
Shop queue / capacityOpen spindle slots fill weeks out on busy cellsAsk for a realistic window early; flag flexible dates so the shop can fill gaps
Material stockNon-stock alloys, thick plate or odd bar sizes need mill lead timePrefer common grades such as 6061 or 304; confirm stock before locking the date
Setups and complexityEach re-clamp adds programming, fixturing and prove-outGroup features on fewer faces; allow a corner radius the shop can reach with a standard end mill
Secondary operationsHeat treat, plating, anodize or painting often leave the buildingCall out finish early; ask whether it is in-house or outside and how long the outside queue is
Inspection depthFull CMM reports and first-article packages take scheduled metrology timeAsk for full FAI only when you need it; use a sampling plan for repeats
Drawing revisionsA change after CAM is written can reset programming and first articleFreeze critical dimensions before release, or order a small prototype first
Incomplete RFQEstimators hold the job until material, quantity and finish are clearSend STEP + 2D drawing, temper, quantity, finish and ship-to in one package

Queue and capacity: the part you cannot see from the CAD

Even a simple aluminum bracket waits for an open machine. Three-axis mills, five-axis cells and Swiss lathes have different queues. A shop may quote a short date on a three-axis prismatic job and a longer date on a five-axis housing because that cell is booked. Sharing a preferred date and a true must-have date gives the planner room to fill a gap instead of forcing overtime.

If your need date is soft, say so in the RFQ. A flexible window often ships sooner than a rigid expedite the shop cannot meet without bumping other work. Expedites depend on idle capacity; they are not a free switch.

Material: stock on the shelf versus mill lead time

Common aluminum (6061), free-machining brass and everyday stainless are often on the shelf or available in a few days. Specialty tool steels, thick titanium plate, odd diameters and certified heat lots can add a week or more before the first chip. If an alternate alloy with similar strength is allowed, ask which option is in stock. Our guides on 6061 vs 7075 aluminum and stainless 304 vs 316 vs 17-4PH show where substitutions are usually safe.

Stock size also matters. A part that fits a standard bar with a few millimetres of clean-up avoids waiting for a special cut. If the envelope is flexible, ask which stock the shop already holds.

Setups, cycle time and why “simple” parts still take days

Cycle time is rarely the full calendar story, but it shapes programming and prove-out. Deep pockets, thin walls, sharp internal corners and features on six faces mean more tools, more CAM and more first-article risk. A vise-held part finished in one or two setups moves faster than a multi-sided housing that needs soft jaws and a five-axis program. Design choices that reduce setups also shorten lead time; see CNC pockets, thin walls and undercuts, and five-axis aluminum housing tips.

Tight tolerances everywhere add finishing passes and measurement. Apply a general tolerance such as ISO 2768-m and tighten only functional features. Leave surfaces as-machined (about Ra 3.2 µm) except on sealing or sliding faces—details are in our surface roughness Ra guide.

Secondary ops and outside processes

Deburring in-house is usually short. Heat treat, Type II or Type III anodize, chem film, zinc plating, powder coat and paint often leave the building. Outside finishers have their own queues—a batch may wait for a tank load or colour match. Call the finish out in the first RFQ, not after metal is cut. Mark cosmetic faces so masking is planned, not discovered at inspection.

When two finishes both work, ask which partner queue is shorter. Our comparisons of chem film vs Type II anodize and zinc plating vs electroless nickel vs black oxide help buyers pick without guessing schedule impact.

Inspection, FAI and documentation

A dimensional spot-check on critical features is quick. A full ballooned first-article inspection report with CMM data, material certificates and a formal FAIR is scheduled work. Ask only for the documentation your quality system needs. For a prototype, a critical-feature check may be enough; for production into regulated programs, schedule a full FAI up front. See our first-article inspection overview for what buyers typically request.

Revisions and incomplete RFQs: the silent schedule killers

Two problems create more calendar slip than almost any machining detail. The first is a revision after CAM is written: even a small hole-size change can force a reprogram and a new first article. Freeze the drawing, or order a short prototype revision A before releasing production revision B.

The second is an incomplete RFQ. Missing temper, unspecified coating, or a STEP with no 2D tolerance drawing all trigger clarification emails. Those days count against your need date even though the spindle has not started. A complete package is the fastest way to start the real clock.

Typical ranges (standard jobs only)

Ranges below are industry-typical for complete RFQs on common materials—not promises for any one shop:

  • Simple 3-axis aluminum or brass parts, in-stock material, light deburr, no outside finish: many shops quote about 5–10 business days
  • Multi-setup or five-axis parts, stainless or tool steel, moderate inspection: often about 8–15 business days
  • Jobs needing heat treat, anodize, plating or a full FAI package: commonly about 10–20+ business days depending on the outside queue
  • Expedites: possible when capacity exists, usually at a premium and only after the shop confirms a real open slot

Treat these as planning bands. Always confirm the quoted ship date on your specific package.

How buyers actually shorten lead time

1. Send a complete RFQ on day one: STEP + drawing, material and temper, quantity, finish, inspection level, ship-to and need date.

2. Prefer stocked materials and standard finishes when function allows.

3. Reduce setups: group features, allow standard corner radii, avoid unnecessary multi-face work.

4. Tighten only functional tolerances and finishes; leave the rest general.

5. Decide documentation level up front—full FAI when required, sampling on repeats.

6. Freeze the design before production release, or plan a short prototype loop.

7. Share a must-have date and a preferred date so the planner can use open capacity.

8. Ask early whether coating or heat treat is in-house or outside, and what that queue looks like.

Illustration 1 maps these levers to the stages of a typical order. Illustration 2 shows how an incomplete RFQ stretches the front of the timeline before cutting even begins.

What to put in the RFQ so the date sticks

  • 3D model (STEP) and 2D drawing with tolerances, threads and finishes
  • Material, temper, and any allowed alternates
  • Quantity now and likely repeat or annual volume
  • Coating or heat-treat callouts, including cosmetic faces
  • Inspection and documentation needs (spot-check, full dimensional, FAI, certs)
  • Preferred ship date and true must-have date
  • Shipping method and destination

Upload that package on quote-new.php. An engineer will review manufacturability and flag features that usually add calendar time—deep pockets, sharp corners, exotic stock or outside finishes—so you can decide before the order is locked.

Common questions

Is lead time the same as cutting time?

No. Cutting time is only one stage. Queue, material, programming, secondary ops and inspection usually dominate the calendar for small and medium batches.

Why did my simple part quote two weeks?

Often because of machine queue or a finish that leaves the shop—not because the geometry is hard. Ask which stage is on the critical path.

Will relaxing tolerances always ship faster?

Only when the tight callouts were forcing extra finishing passes or CMM time. Tolerances the shop already holds easily do not move the date much.

Can I speed up anodizing or plating?

Sometimes by choosing a common finish the partner already runs in volume, or by accepting a standard colour and thickness. Special colours and masking add time.

Does 3DWK review schedule risks with the quote?

Yes. When you upload files on the quote page, the review covers manufacturability and the usual schedule drivers so you can adjust material, finish or documentation before committing.

Next step

Questions about your design?

Upload CAD files and an engineer will review manufacturability with your quote.

Upload CAD
